Case Studies
IT

20 Developers, an Hourly Rate, and No Idea What the Project Actually Made

Oleksiy Bazyura
Oleksiy Bazyura
Financial Expert at Finmap

"I knew every developer's hourly rate. I knew the client's contract rate. I subtracted one from the other and thought I knew the margin. Then I built a per-project P&L and realized I'd been running a business on a fiction for four years."

A founder of a services-and-outstaff IT company — 20 developers, ₴36M annual revenue, seven active clients — described the exercise that changed how she priced work and hired.

For four years she had run the business on what everyone in the industry runs on: hourly rate math. Each developer had a cost rate (₴550/hour, on average). Each client had a contract rate (₴950/hour, average across clients). Simple subtraction said ₴400/hour gross margin per developer, ~42% margin. Extrapolated across the team: comfortable, profitable, growing.

Then she did the exercise. Take one project. Not the "we billed the client ₴X per hour" number. The actual project P&L. Client revenue for the month. All costs directly attributable to that project. All costs indirectly attributable. What's left.

Project margin on her flagship client, over the previous 12 months: 14%. Not 42%.

Twenty-eight points of margin had disappeared into a set of costs the hourly rate math didn't touch.

What the Hourly Rate Math Actually Hides

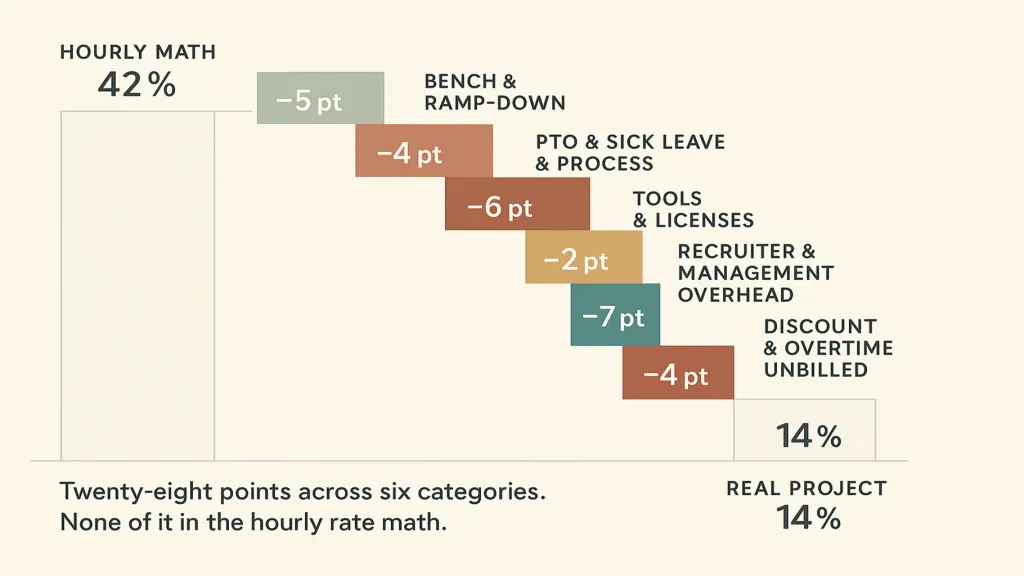

The hourly rate assumes a developer is 100% utilized on the project, 100% productive during that time, and the project consumes only their labor. None of those are true for any real services business. Where the 28 points went — vector waterfall. Left: HOURLY MATH MARGIN 42%. Six drops: BENCH & RAMP-DOWN −5pt, PTO & SICK LEAVE −4pt, INTERNAL MEETINGS & PROCESS −6pt, TOOLS & LICENSES −2pt, RECRUITER & MANAGEMENT OVERHEAD −7pt, DISCOUNT & OVERTIME UNBILLED −4pt. Right: REAL PROJECT MARGIN 14%. Brand teal accent on management overhead drop (largest). Bench and ramp-down (−5 points). When a project ends or a client pauses, the developer is idle but still paid. Two weeks per year, on average, per developer. Not billable. Comes out of margin.

PTO and sick leave (−4 points). Salaried developers get paid vacation and sick time. Contract rate is billed only when they work. The gap is invisible until you count.

Internal meetings, process, hiring interviews (−6 points). Standups, retros, planning, interviewing candidates, internal syncs. All paid, none billable. On average 4–6 hours per developer per week.

Tools and licenses (−2 points). IDE licenses, cloud infrastructure for internal environments, project management tools, monitoring, communication platforms. Small per unit; adds up.

Recruiter and management overhead (−7 points). HR, delivery managers, project managers, the founder's own time. All get paid. Almost never billable. This was the biggest single leak.

Discount and overtime unbilled (−4 points). Client pushed back on rate at renewal, granted 8% discount. Emergency work done on weekends not always tracked. Overrun on fixed-scope portions absorbed.

Twenty-eight points, six categories, none in the hourly rate math.

The Rebuild — Project P&L Framework

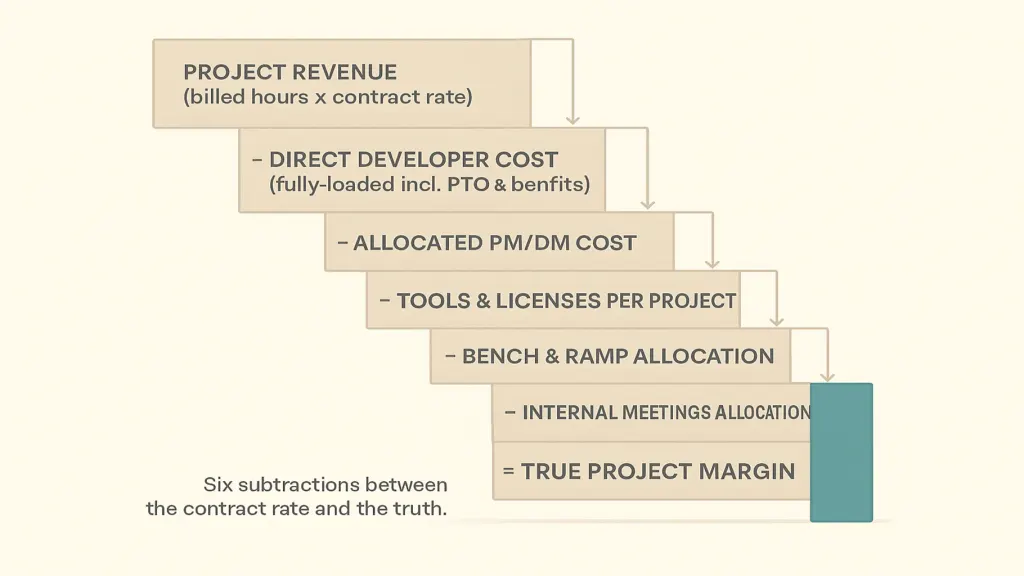

The founder built her per-project P&L over a weekend. It became the single most important document in her business. Framework applies to any services company. Per-project P&L stack — vector vertical waterfall. From top: PROJECT REVENUE (monthly billed hours × client rate) − DIRECT DEVELOPER COST (fully-loaded, incl PTO & benefits) − ALLOCATED PM/DM COST (% of PM time on project × PM salary) − ALLOCATED RECRUITMENT & HR (per developer allocation) − TOOLS PER PROJECT − BENCH & RAMP ALLOCATION − INTERNAL MEETINGS ALLOCATION = TRUE PROJECT MARGIN. Brand teal on TRUE PROJECT MARGIN row. One — Project revenue. Monthly billed hours × client contract rate. Not sales committed; actually billed.

Two — Direct developer cost, fully loaded. Salary + taxes + benefits + equipment amortization + paid time off, divided by utilization hours (not calendar hours). If a developer is billable 65% of the time, their fully-loaded hourly cost is salary/(hours × 0.65).

Three — Allocated project management, delivery management, and recruitment cost. Rough share by project size or by revenue. Doesn't need to be perfect. Needs to be consistent.

Four — Tools and licenses attributable to the project.

Five — Bench allocation. Total bench cost for the year, divided across active projects.

Six — Internal meetings and process allocation. Percentage of paid hours going to non-project work × allocated cost.

Result — True project margin. For her flagship client: 14%. For two smaller clients: 21% and 8%. For one client she thought was her best: 3%.

What She Did With the Truth

The 3% client got a rate increase conversation. It went well; margin went to 12%. The 8% client had scope discipline problems (over-serving) that were fixable; margin went to 15%. Recruitment overhead was renegotiated with a fixed monthly retainer instead of per-hire fees. Internal meetings were audited — three weekly recurring meetings were killed. Utilization for two of her senior developers went from 58% to 72% by moving them off bench-heavy internal work onto client work. Project margin dashboard — light mode. Title 'Projects · Q3'. Top: 7 project rows, each with client, monthly revenue, developer cost, PM allocation, other overhead allocation, true margin (green/amber/coral chips). One row highlighted: 'Client X — margin 3% → 12% after rate increase'. Center: utilization heat-strip per developer showing bench vs billable time. Bottom: 'Bench cost this quarter ₴240K · target ₴150K'. Brand teal on rate-increase action chip. Overall company margin went from apparent 42% (fictional) to real 19% (before rebuild) to real 27% (six months later). More important than the number: she now knew which client was actually profitable, which was subsidizing bench, and which was quietly costing her money.

The Framework — What to Track

Six numbers, monthly, per project:

  • True billable hours (not committed hours; actual)
  • Fully-loaded developer cost per project
  • Allocated management overhead (PM/DM/recruiter/founder time as % of month)
  • Bench allocation (this month's bench cost × project's revenue share)
  • Project true margin (revenue − everything above)
  • Utilization per developer, tracked separately from margin

Six numbers, one dashboard, monthly review with the delivery lead. Two hours a month, keeps the fiction from returning.

📌 Want to see whether your projects are actually as profitable as your hourly rate math suggests? Send us three months of billing data and team cost breakdown — we'll build the per-project true-margin waterfall and walk you through it in 15 minutes. Request your free Finmap diagnostic →
